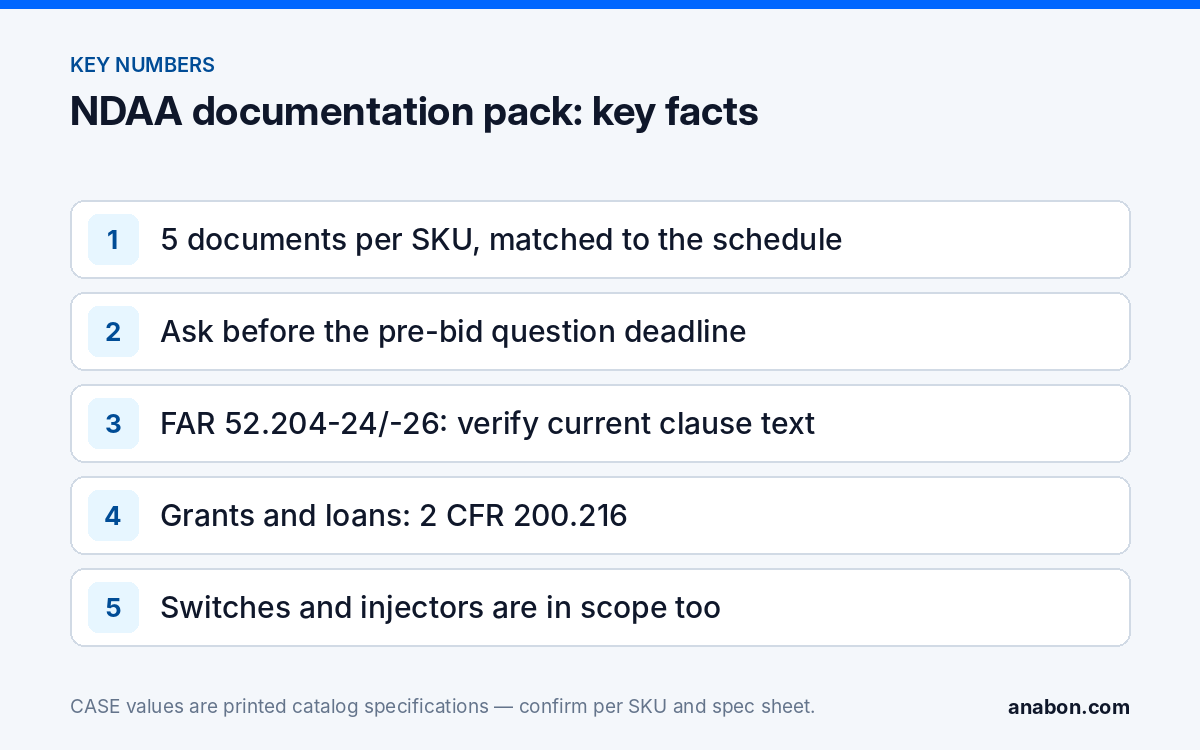

Quick answer: Build the documentation pack around the actual bid and exact offered models. Keep supplier facts, the offeror’s representations and the buyer’s acceptance separate. A brochure label or a letter for another model is not a complete project file.
On this page
What should be resolved before you request documents?
Send the actual solicitation clauses, equipment schedule and deadline. Identify the party submitting the offer and the person authorized to sign its representations. State whether the buyer asks about the supplied equipment, the offeror’s use of covered equipment/services, or additional requirements.
FAR 52.204-24 addresses representations and disclosures, while FAR 52.204-26 includes representations following a reasonable inquiry. The responsible offeror must resolve its own obligations; a distributor’s product statement cannot automatically answer every organization-wide use question.
| File or record | What it should identify | Review point |
|---|---|---|
| Requirement extract | Solicitation/contract identifier, exact clauses, scope and deadline. | Which questions must actually be answered? |
| Equipment schedule | Full SKU, proposed manufacturer/producer information, quantity and revision/configuration where relevant. | Do all supporting statements match these items? |
| Supplier/manufacturer statement | Issuer, date, exact models, scope, qualifications and supporting facts. | Is it a product statement or does it answer a broader use/contractor question? |
| Offeror representations | Required forms and the party authorized to complete them. | Has the responsible offeror made its own required inquiry? |
| Technical documents | Actual revision sheets, integration requirements and relevant software/firmware scope. | Do not imply a document proves an unrelated compliance requirement. |
| Open-items register | Question, missing document, owner, due date and decision. | No blank field silently becomes an approval. |
| Substitution/change record | Old/new model, differences and accepted revised evidence. | Is the installed schedule still the accepted offer? |
How do you ask a useful exact-model question?
Use a short request such as: “For the attached requirement and equipment schedule, please identify the available supporting statement for each full SKU and its revision/configuration scope. Please list any qualification or question the statement does not answer.” Attach only the relevant project material and avoid sending unnecessary customer secrets.
Where the bid also mentions origin, FCC authorization, certifications or integration, create a separate evidence line for each. Identify the actual requirement and supporting document; these are not one interchangeable compliance tick box.
How do you review a statement when it arrives?
- Check the issuer and date, then match every model suffix and lens designation to the offer.
- Read what the statement actually covers: equipment, services, revision, region, firmware or other limits.
- Keep qualifications visible in the evidence register and proposal.
- Record which question remains open and who will obtain the answer.
- Confirm who accepts the evidence under the customer’s procurement process.
Do not create an official-looking certificate to fill a missing answer. If a brand or distributor statement is too broad or too narrow for the question, request clarification rather than rewriting it. Anabon’s document resource for NDAA compliant cameras is a starting point. Obtain a dated statement or addendum identifying the offered models and relevant limits. A public brand statement does not replace the offeror’s representation or the buyer’s acceptance.
What should the bid and handover share?
The accepted equipment schedule should continue into purchasing and commissioning. Record serial/model identity where appropriate, retain the supporting documents and track approved substitutions. If the delivered revision differs, resolve its effect on the relevant statement before calling the file complete.
Keep the regulatory question with the project file. For document assistance, the project compliance-documentation service guide describes the request context; it does not remove the need to identify the actual requirement and accepting party.
What if the deadline arrives with an open item?
Make the gap explicit and ask the responsible project party how it must be handled. Do not tick “compliant” solely to complete a form or promise that evidence will definitely arrive later. A conditional technical alternative and a clear open-item owner can be more useful than an unsupported assurance.
FAQ
Is a product letter the same as the offeror’s representation?
No. They have different issuers and scopes. Keep both in the file when the procurement requires them. For example, where FAR 52.204-24 is used, follow that provision’s representation and disclosure steps for the responsible offeror. A supplier letter remains limited to its stated scope.
Can one statement cover every CASE model?
Use only its stated scope. Match the exact offered items and request clarification where a model or revision is not addressed.
What changes after a substitution?
Update the schedule, technical comparison and relevant supporting evidence, then follow the project’s approval process.
What should you send Anabon before equipment selection?
Provide the bid requirement extract, full SKU/revision schedule, required forms, submission date and current open-items list. Ask for the available evidence and its limitations. For model-specific documentation questions, contact security camera technical support before equipment selection; the responsible offeror and buyer still resolve the actual representation and acceptance.
References
References checked October 29, 2026. This guide organizes document requests; it does not establish that every product or offer satisfies a particular procurement. Confirm the current clauses, required form/version and actual project scope before a commitment.
- FAR 52.204-24 — representations and disclosures
- FAR 52.204-26 — covered equipment/services representations
