Field guide · Project & Bid Support

Writing a Camera Schedule Template and Bill of Materials (BOM)

Build a camera schedule and BOM that connect each required view to exact equipment, compatible parts and tested recording performance. Track assumptions, approvals and changes while protecting private project details.

By Anabon Security Inc. — Technical Support · 8 min read · For installers, integrators and dealers

Quick answer: Use a camera schedule to connect each actual view/task to its full device identity, lens, mounting, compatible power, network/recording path and acceptance test. Use a separate BOM row for each exact part/revision and quantity. Mark assumptions and approvals clearly and version both records. Keep private pricing, credentials and sensitive network details in appropriately restricted documents rather than a widely distributed schedule.

On this page

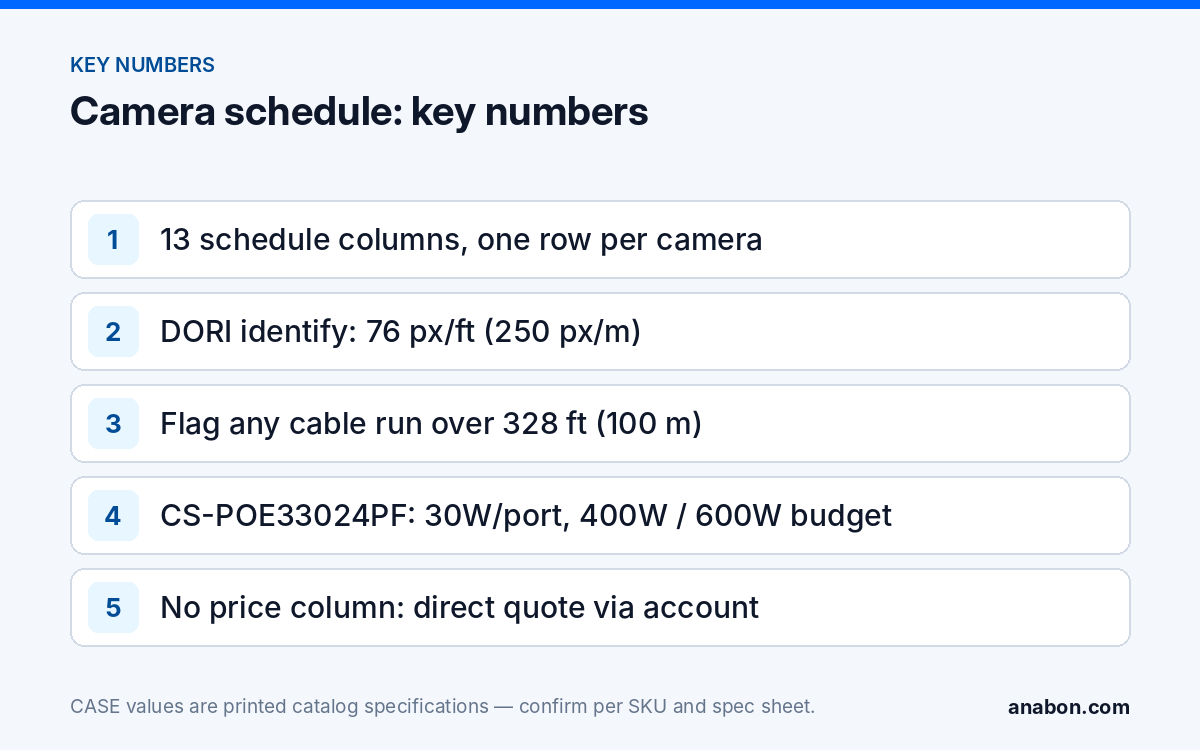

Which columns in a camera schedule actually prevent change orders?

A clear schedule can reduce misunderstandings about required views, optics, mounting, cable paths, power and retention. It cannot prevent every change order. Record the approved assumptions, responsibilities, site verification and change-control process rather than promising the spreadsheet makes every part or cost final.

Which columns in a camera schedule actually prevent change orders?
Schedule field Record Verification
Stable camera ID / drawing reference Unique ID tied to current drawing and actual channel mapping Do not use an IP or channel number as the only identity
Required task / target / conditions Detail, distance, angle, movement, light and relevant acceptance criterion/edition Actual recorded target test; not just a DORI label
Full SKU / revision / lens Exact catalog/spec identity and required optics/settings Approved current equipment and field of view
Mount / surface / height / access Actual compatible assembly, load, entry parts and safe service access Exact model/structural/environment instructions; no universal height or box
Power Supported source/class, maximum/startup PD load, per-port/shared budget and losses Actual revision and worst relevant conditions; not port count alone
Cable / network path Approved channel, patching, medium, route and permitted service/media flows Qualified design, actual tests and local requirements
Recording / events / retention Agreed streams, policy, storage assumptions, access and required functions Actual resource and recorded/search/export acceptance
Status / sources / revision Proposed,approved,installed,tested with evidence and approver A pending assumption is not approved or tested

DORI levels in plain numbers

Name the required criterion and edition. The familiar DORI values25/62.5/125/250 px per metre belong to the 2014 IEC62676-4 approach; the 2025 edition changes the task/pixel-density framework. Do not present the old table as the unqualified current standard or a guarantee of identification. A fixed2.8 mm or varifocal focal length alone does not establish target performance: sensor/output, view width, angle, motion, lighting and recorded quality matter. Agree the actual task and test; Turret vs Dome vs Bullet Cameras covers housing choices.

Example rows

Which columns in a camera schedule actually prevent change orders?
Example position Candidate only Items still to approve
C01 entrance CS-I5XS SD-2.8mm,2.8 mm fixed Actual required view/target, mount and height, power, route, recording and test
C02 rear door CS-I5XS SD-2.8mm only if its actual view fits No automatic identification distance or universal shared junction box
C03 loading area CS-I8MS SD-2.7-13.5mm,actual approved lens setting Required view and moving-target result, compatible assembly, peak power and path/recorder resources

Why do accessories and the PoE layer belong on the same sheet?

Include the approved devices and all required compatible parts, with exact revisions, quantities and source/approval references. Add actual written warranty/order terms, not a blanket category formula. Current powered accessory catalog badges can differ from the general accessories wording; confirm the exact product. Keep labour, drive coverage and project exceptions separate.

Why do accessories and the PoE layer belong on the same sheet?
BOM example Quantity rule Relevant catalog/source check
CS-I5XS SD-2.8mm From approved positions, not a fixed example count PDF13:5 MP,IR30 m,white light15 m,IP67,Metal+Plastic; exact task/power still needs verification
CS-I8MS SD-2.7-13.5mm From approved positions PDF7:3840×2160 at 20fps,2.7–13.5 mm,IP67/IK10; do not substitute a similar SKU
Exact compatible box/mount/entry parts From each verified camera/assembly Do not order one universal box for every position; exact full revision/lens compatibility
CS-N220 P16H-AI From approved resource/design plan PDF55:20 channels,16 PoE,160 input (AI on 120)/80 output Mbps; exact power/bays/decode needed
Approved HDD model/revision After confirmed bay/usable-capacity and retention design Separate drive-maker warranty and approved workload/compatibility
CS-POE33024PF variant After approved topology and source/load calculation PDF63:24 Gigabit PoE,2 SFP,30 W per port,variant budget/full-load rows requiring confirmation;6-year badge, exact written terms
Cable,patching,optics,protection,rack and interface parts Actual verified routes and compatible host/assembly requirements Qualified routing,local code,environment,power and network design; do not invent approvals

The PoE budget check

Compare actual source/class and PD maximum/startup requirements with cable losses, per-port limit, shared available budget, temperature and reserve. CS-POE33024PF’s24×30 W arithmetic is720 W, above either400/600 W budget row, but the exact variant and published full-load figures also need confirmation. Do not assume every camera draws30 W or every near camera belongs on built-in ports. A conventional100 m Ethernet channel limit is not a universal PoE guarantee; fibre, compatible extenders or another approved path need actual host/power/cable design. PoE Max Distance and PoE Extenders and PoE Camera Not Powering On cover the checks.

How does the schedule turn into a quote request?

  1. Identify the approved drawing/schedule/BOM revision, date, assumptions, responsible parties and any pending decisions.
  2. Verify full current SKUs/revisions, exact compatible assemblies and supported functions; retain approved alternatives and differences rather than silently replacing a retired/unlisted part.
  3. Send only the necessary quantities, part identities and project requirements through an authorized private route; separate restricted pricing, credentials and sensitive network/site details.
  4. Request exact product documentation, applicable written terms, stock/lead time and actual compliance/project confirmation before commitment. A brand statement is not a certificate or approval.
  5. Record the returned quote/reference and exceptions against the same baseline, then handle changes through the agreed approval process.

Project-quoted equipment requires exact current identity and written availability, lead time, relevant certificates and warranty for that project. A CSP prefix is a clue, not proof that every thermal, radar or LPR product has the same status; do not promote a retired example as available. How to Read a Video Surveillance RFP covers aligning the actual requested documents and exceptions.

How to set the template up in your own spreadsheet

Use separate schedule and BOM tabs with unique IDs, source references, statuses and revision history. Validate the actual criterion/edition, mount, power and recording fields rather than imposing an old DORI list. Flag path constraints for qualified review; a 100 m warning alone cannot certify a cable or power design. Keep appropriately restricted records for pricing, network details and credentials; a hidden/protected spreadsheet tab is not a confidentiality boundary.

How does the schedule become the as-built at handover?

  • Replace approved assumptions with actual installed identities, settings, routes, compatible assemblies and relevant test evidence; do not invent a measurement where none was taken.
  • Mark tested only after the agreed recorded task, lighting/movement and relevant event/search/export checks pass, with limits and unresolved items recorded.
  • Keep authorized actual channel/network mappings and usable retention/access configuration in the appropriate controlled record.
  • Deliver the agreed final revision and closeout evidence to the authorized recipients. Transfer credentials separately through a protected approved process, not in a general drawing/BOM pack.

What to tell your customer

The schedule records the approved task and exact equipment/path for each camera, and the parts list follows that approved revision. We will verify the actual installation and recorded results, document changes and deliver the agreed closeout record. The documents make assumptions and changes visible; they do not guarantee that no extra part or cost can arise.

FAQ

What is the difference between a camera schedule and a bill of materials?

The camera schedule is one row per camera position: where it goes, what it must see, which SKU and lens, how it is mounted, powered, cabled and recorded. The bill of materials is one row per part number with a quantity: cameras, recorder, drives, switches, boxes, mounts and cable. The schedule explains the design; the BOM is what gets ordered.

Why does the template have no price column?

The design/ordering schedule should contain only what its authorized recipients need. Keep private unit costs/account prices separate and issue the customer proposal under the actual agreed pricing/channel terms. CASE’s above-announced-MSRP public-display exception does not authorize publishing private account prices or every project file. The installation proposal guide helps organize the separate customer-facing scope.

How do I fill the PoE class column when the catalog does not print it?

Obtain the actual revision’s compatible source/class and maximum/startup power requirements, noting whether a value is at the source or powered device. Mark missing evidence pending; do not replace it with an estimate or approval. Then check per-port/shared source capacity, losses, temperature and reserve with the actual design rather than just summing class names or camera counts.

What are DORI levels and why are they in the purpose column?

The familiar Detect/Observe/Recognize/Identify table is associated with the 2014 IEC62676-4 framework; the 2025 edition has a changed task/pixel-density approach. Specify the actual required criterion and edition, target/scene conditions and acceptance test. A pixel-density label or focal length alone cannot guarantee identification in the recorded scene. See the 2025 pixel-density explanation for the updated task framework.

References

  • Anabon: exact product/revision documents
  • Anabon Technical Support
  • IEC:62676-4:2025 official publication
  • Axis: pixel density under IEC62676-4:2025
  • Axis: legacy2014 DORI framework
  • Google Sheets: protection/hiding limits


Product documents and project support

Match the current product documents to your full equipment schedule before quoting.

Private pricing is available through your approved business account. Confirm the exact model, revision, required functions and written warranty terms for your project.
