Quick answer: Start with the actual solicitation instructions, deadlines, mandatory conditions and issued changes, then read the related scope, drawings, equipment, testing and closeout requirements together. Follow the project’s own section numbers and substitution/approval procedure. Build a traceable compliance matrix and resolve any mandatory gap through the permitted process before bidding; a familiar brand, section title or “or equal” phrase does not establish acceptance.
On this page
What does a Division 28 RFP package actually contain?

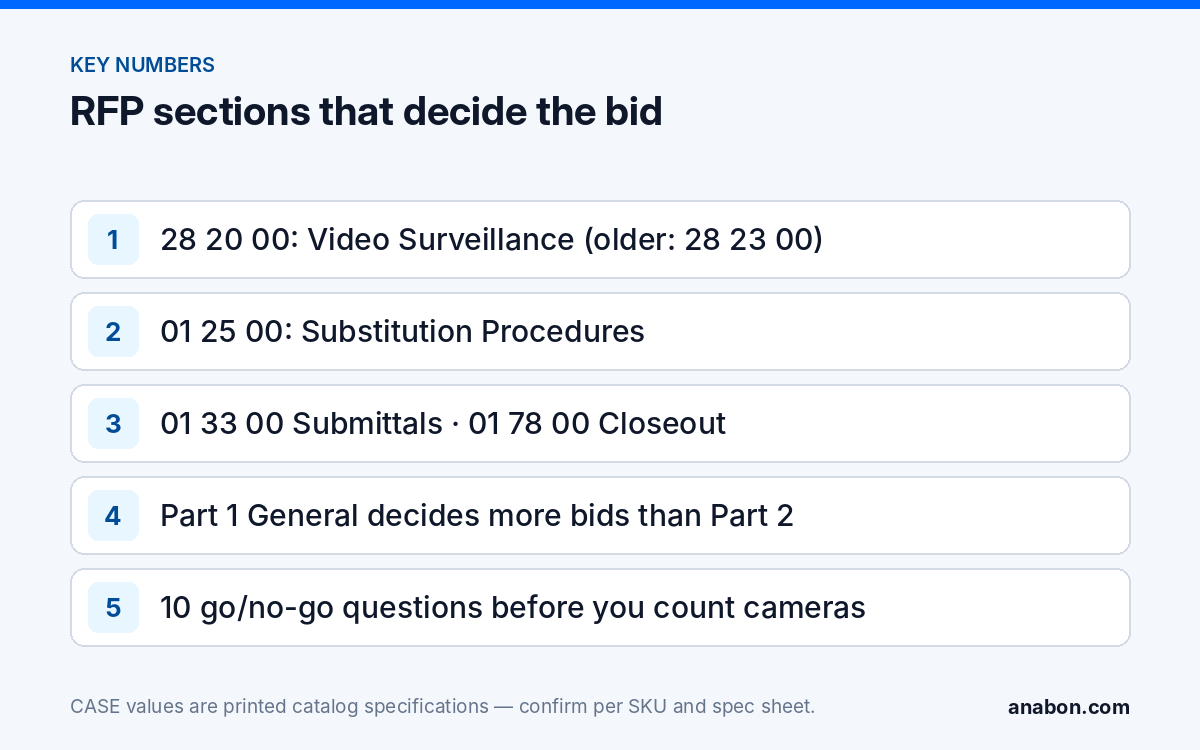

Many North American construction packages use MasterFormat/SectionFormat organization, but procurement and contract rules vary by owner, jurisdiction, project and edition. Some RFPs use another structure. Use the actual contents and document-precedence rules rather than assume Canada differs only by the portal or every video section has one universal number:
| Package area | What to review |
|---|---|
| Solicitation / procurement / contract instructions | Actual eligibility, submission method/time zone, deadlines, questions, mandatory meetings, bonds/insurance and evaluation rules |
| General requirements, if organized as Division01 | Actual substitutions, submittals, testing, training, closeout and release/approval conditions |
| Related electrical/communications scope | Power, cable/raceway, grounding, network and responsibility interfaces across drawings and trades |
| Project’s surveillance/security sections | Actual performance, product/documentation, warranty, installation and acceptance clauses; use the project number/title |
| Drawings, schedules and existing-system information | Required tasks, counts, locations, paths, assumptions, access and integration; log conflicts |
| Issued addenda/clarifications | Obtain the authorized current set, follow actual precedence/acknowledgment rules and carry changes into the bid |
A common three-part specification structure is General, Products and Execution, but it is not proof that every project uses that format or puts all disqualifying clauses in one part. Read the entire referenced package. Do not call28 23 00 a legacy-only video-surveillance number: NRC’s current NMS contents still list Video Surveillance there. The project’s actual section and edition govern.
How do you read the basis of design and the “or equal” language?
Identify the named equipment, salient requirements and actual alternative/substitution process. Similar phrases can have different effects under the solicitation; none automatically guarantees that an alternative can wait until post-award review. Check:
- Whether alternatives are permitted at all, and the exact request/approval authority, form, deadline and required evidence.
- What must be identified or submitted with the bid, and whether written pre-bid acceptance is required.
- How deviations, alternates or qualifications may be stated without making a submission nonresponsive.
- Which requirements remain the bidder’s responsibility even after a proposed-product review.
- If unclear, use the owner’s authorized question/clarification route before its deadline; do not rely on an informal supplier opinion or a generic seven-to-ten-day rule.
What a substitution request must contain
Use the required form and identify the exact section/paragraph, full proposed SKU/revision and each applicable requirement. Link every comply/exceed/deviate/pending entry to specific current evidence and disclose differences affecting power, mounting, network, software, service or other trades. Anabon can help assemble exact product/project documents, but cannot promise owner acceptance. Where FAR 52.211-6 is actually included, read its identification/descriptive-literature requirements; do not apply it automatically to every private or Canadian bid.
Which compliance and documentation clauses can disqualify a bid?
Classify each actual clause as mandatory, evaluated, post-award deliverable or clarification needed. Record the evidence, owner and deadline that the solicitation actually requires. An absent cut-sheet line does not by itself prove noncompliance, and a marketing label does not prove compliance:
- Procurement restrictions: Section889/FAR, FCC, TAA, domestic-preference and Canadian project rules are distinct checks. Identify the actual clauses and obtain exact current product/project evidence and qualified review. CASE offers NDAA-compliant options; that is not a declaration for every SKU or system. What Is NDAA Compliance for Security Cameras? gives planning context.
- Product approvals/listings: obtain the actual required certificate/listing/declaration and verify model, revision, scope and issuer. CS-POE33024PF’s published certification row is not proof of every UL/ULC, FCC procurement or project requirement. Mark missing evidence pending; state a deviation only when the actual requirement cannot be met through the permitted process.
- Interoperability: confirm the exact supported device/client versions and required functions. ONVIF Profiles S, T, G and M Explained separates profile scope from end-to-end acceptance; no brand-wide support or a playable picture proves every event/search function.
- Cybersecurity/privacy: identify actual access, firmware, network, logging, recording/retention, notice and data-handling deliverables. Hardening a CASE NVR is a planning guide, not automatic certification or legal permission for audio/biometrics.
- Qualifications: check the actual licence, training, references, insurance, bonding and eligibility requirements and deadlines; do not invent a universal trade licence for every jurisdiction.
What do the warranty, training and as-built clauses commit you to?
Estimate the project’s actual warranty, submittal, testing, training, service and closeout obligations wherever they appear. Agree responsibility, acceptance and approved release conditions before assuming a supplier quote covers all post-installation work:
| Obligation | Record before commitment |
|---|---|
| Product warranty | Exact confirmed SKU/order start, term, scope and exceptions; compare with the requested obligation, including drives, powered accessories and projects |
| Contractor/service warranty | Actual labour, travel, response, loaner and maintenance duties, costs and permitted agreement terms; do not invent a standard one/two-year rule |
| Submittals / ordering release | Required data, drawings, approvals and authority to release work; review status is not a universal performance guarantee |
| Commissioning / acceptance | Required recorded tasks, conditions, functions, witnesses, evidence, punch list and re-test scope |
| Training | Actual sessions, attendees, materials, recording/access and handover requirements |
| Closeout | Approved as-built/equipment/source records, manuals and authorized data delivery; credentials transferred separately by a protected process |
For the schedule format that carries from bid to as-built, see Writing a Camera Schedule and Bill of Materials.
Go or no-go: the ten questions to answer before you bid
- Can I meet the substitution procedure by its deadline with documents in hand, or is the spec closed?
- Can I produce every compliance document the spec names, per SKU, before the bid is due?
- Does the warranty clause match the CASE category terms, or do I have a deviation to state or a contractor warranty to carry?
- Have I read every addendum and carried each change into the count and the bid form?
- Is cabling, conduit and power in my scope or another trade’s, and does the drawing set agree with the spec?
- Does the schedule count match the drawings, and have I walked the site or attended the pre-bid?
- Do the integration, VMS and analytics requirements have written confirmation?
- Can I meet the qualification clauses: license, references, bonding, insurance, trained staff?
- Have I estimated submittals, commissioning, training and closeout as labor?
- Do I know the award criteria (lowest responsive bid, best value, points) and who evaluates?
One unresolved mandatory condition can be enough to prevent a compliant bid; there is no universal “two no answers” threshold. Identify who can authorize a clarification or permitted alternative and the real deadline. If the mandatory gap remains unresolved, do not represent the bid as compliant or assume a later contractor-warranty line will cure it.
Where do you find open video surveillance bids?
Use the issuing agency’s current official portal and documents as the authority for scope, status, eligibility, deadlines and addenda. Anabon’s security camera bid opportunities page can help discover relevant opportunities, but an aggregator is not the final current package or a guarantee the opportunity is still open. Anabon supports the bidding partner with product/project documentation and planning; the actual bid and contract remain the partner’s responsibility.
What to tell your customer
We will review the actual current package and record the required evidence, assumptions and unresolved points. Any proposed alternative will follow your stated procedure with exact product identification and disclosed differences. We will claim compliance only where supported and confirm actual product/service terms, rather than promise acceptance from a general brand description.
FAQ
What is Division 28 in a video surveillance RFP?
Division28 commonly organizes Electronic Safety and Security work in MasterFormat-based packages, but the actual project index and edition matter. The NRC NMS table lists Video Surveillance at 28 23 00; it is not correct to call that number legacy-only. Read related general, trade, drawing and contract requirements as well as the surveillance section.
What does “or equal” mean in a camera specification?
Read the exact solicitation and incorporated procedure. An “equal” offer may require identified products, evidence, disclosed modifications and approval at a particular time; the phrase alone does not authorize waiting until after award. Ask through the official question route if ambiguous and do not promise acceptance on the owner’s behalf.
Does NDAA Section 889 apply to Canadian bids?
Identify the actual governing procurement and incorporated clauses rather than treating U.S. Section889/FAR, FCC restrictions and Canadian requirements as one certificate. A Canadian project can request its own or referenced evidence; the actual package and qualified procurement/legal review determine what must be demonstrated. Anabon’s options/documentation statement must still be confirmed for the exact products and project. The Section 889 planning guide helps separate supplier documents from project acceptance.
The RFP demands a five-year warranty on every device. What do I do?
Compare the exact manufacturer/product terms, start convention, scope and exceptions with the actual five-year requirement. A gap is not automatically cured by calling it a contractor warranty; that creates a separate potentially costly obligation and may not satisfy the clause. Use the permitted clarification/alternative process and qualified contract review before committing. Never promise six years or unlimited coverage for every item. Read the CASE warranty by category guide before recording exact product terms.
