Quick answer: Choose a construction camera design from dependable power, a tested communications path and the evidence needed in the current site phase. Keep essential views fixed, size any solar system for the complete seasonal load and agree relocation and service responsibilities. A trailer or PTZ specification is not a guarantee of uninterrupted coverage.
On this page
Survey today’s site and the next move
Meet the site manager and electrical contact. Mark the gate, material storage, office, equipment routes and planned work zones. Ask when cabins, fences, cranes and power supplies will move. A view that works at mobilization can be blocked or removed during the next phase. Write the evidence tasks and accepted gaps into a phase plan. The aim may be reviewing an after-hours entry or material movement, not observing every operation. Keep the camera contract distinct from the site’s safety, access control and emergency arrangements.
Verify what temporary power actually provides
Ask the qualified electrical contact to confirm the approved supply, installation and operating hours. A generator or temporary socket available during the survey may be switched off at night. Do not describe temporary power as dependable without checking the actual site practice and responsibility. Use the Anabon Download Center to locate available exact-model documents; a data sheet does not approve the site’s electrical arrangements.
| Option | Confirm before quoting | Acceptance check |
|---|---|---|
| Site-powered installation | Approved supply, continuity and protection | Agreed after-hours operation and fault recovery. |
| Solar or battery system | Complete load, worst season and charging design | Documented autonomy assumptions and maintenance checks. |
| Cellular or wireless link | Actual coverage, data needs and supported equipment | On-site connection and approved outage behaviour. |
| Relocatable mount or trailer | Structural/site approval and move procedure | New framing, stability, power and recording after each move. |
Choose IP cameras for each approved task and check the power requirements of every exact device. A high-power PTZ is not automatically supported by an ordinary PoE port. Compare PoE network switches with per-port and total requirements rather than matching connectors by appearance.
Calculate the complete remote load

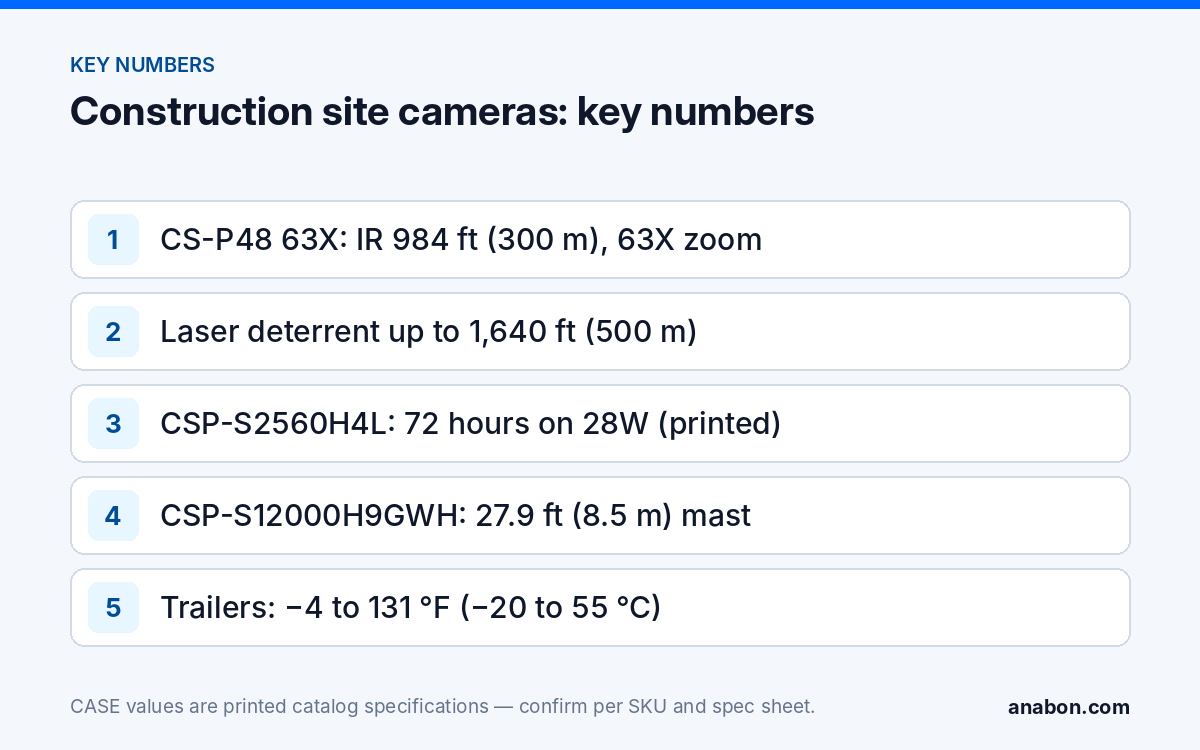

Include cameras, illumination, radio or cellular equipment, recording, controllers and heating. Use each device’s documented load and operating schedule; a published runtime belongs to its stated test conditions. Size for the actual site’s seasonal daylight, shading, battery operating/charging limits, conversion losses, maintenance and fault response. Record the assumptions and confirm the design in writing. Do not turn a published runtime into a promise for added cameras, all-winter operation or seventy-two hours under any load.
Keep essential evidence while the PTZ moves
A PTZ camera can help an operator inspect a selected area, but it cannot face every direction at once. Keep the required gate or material-access view available when it looks elsewhere. Review normal machinery, fencing and stored materials; then test saved footage after dark with normal work lights and authorized vehicle movements. Check glare, vibration and obstructions. For any supported audible/visible deterrent, confirm the trigger, schedule and response for legitimate workers and neighbours. A warning is not a guarantee against theft.
Separate local recording from the remote link
Select the recorder or other approved recording arrangement for the actual channels, supported bandwidth, usable storage and project conditions. Plan capacity against the owner’s approved target and record which device stores each required view. Test the agreed communications-loss scenario safely: establish what continues locally, what is unavailable remotely and how recovery is checked. An app live view does not prove recording or retention. Verify any notification, sharing or remote-management function for the exact model, firmware, platform and supplied configuration.
Recommission after every meaningful move
Agree who can move the installation and who authorizes the new position. Use the site’s approved structural, electrical and access methods; do not improvise mounting to plant or structures without permission. Keep the equipment and camera work outside unsafe work routes. After a move, check power, link, time, recording, labels, framing and night performance. Update the as-built plan and accepted views. A previously successful test does not establish the new position, and a disconnected device must not remain listed as active coverage.
Quote the ongoing service clearly
A monthly arrangement should state equipment ownership, data/connectivity costs, visits, moves, response hours and what the customer checks. Confirm the exact support and warranty terms separately; do not promise that a rental fee guarantees profit or covers every future relocation. Use the customer handover checklist to record the agreed service, access and footage-preservation responsibilities.
Give the owner named roles and secure recovery. Keep installer service access separate and revoke it when the arrangement ends. Document incident preservation and export responsibilities, including how footage is retained when equipment leaves the site.
Accept an event and a recovery procedure
Record a harmless authorized journey, retrieve it, export it and replay it with the site manager. Leave the phase plan, tested conditions, power/load assumptions, configuration and service contacts. Supply the available exact-model documents and schedule the next review before the known site change.
FAQ
Is solar always better than temporary site power?
No. Compare dependable supply, seasonal load, communications and service needs for the actual site. The farm remote-power planning guide covers related seasonal and communications questions without setting a construction-site runtime.
Can a moved trailer keep the same accepted coverage?
Not automatically. Recommission the new position and update the plan, tests and customer acceptance.
Review the difficult site assumptions
Send security camera technical support the phase plan, power confirmation, remote locations, relevant night photographs and recording target. Identify the actual site assumptions that still need confirmation before a quote or acceptance.
References
References reviewed October 30, 2026. Use the actual project’s qualified installation requirements and exact equipment documents. This guide does not establish a safety-system design, a universal runtime or an equipment autonomy commitment.
