Field guide · Project & Bid Support

Security Camera Lead Times 2026: Quote Validity, Substitutions and Phasing

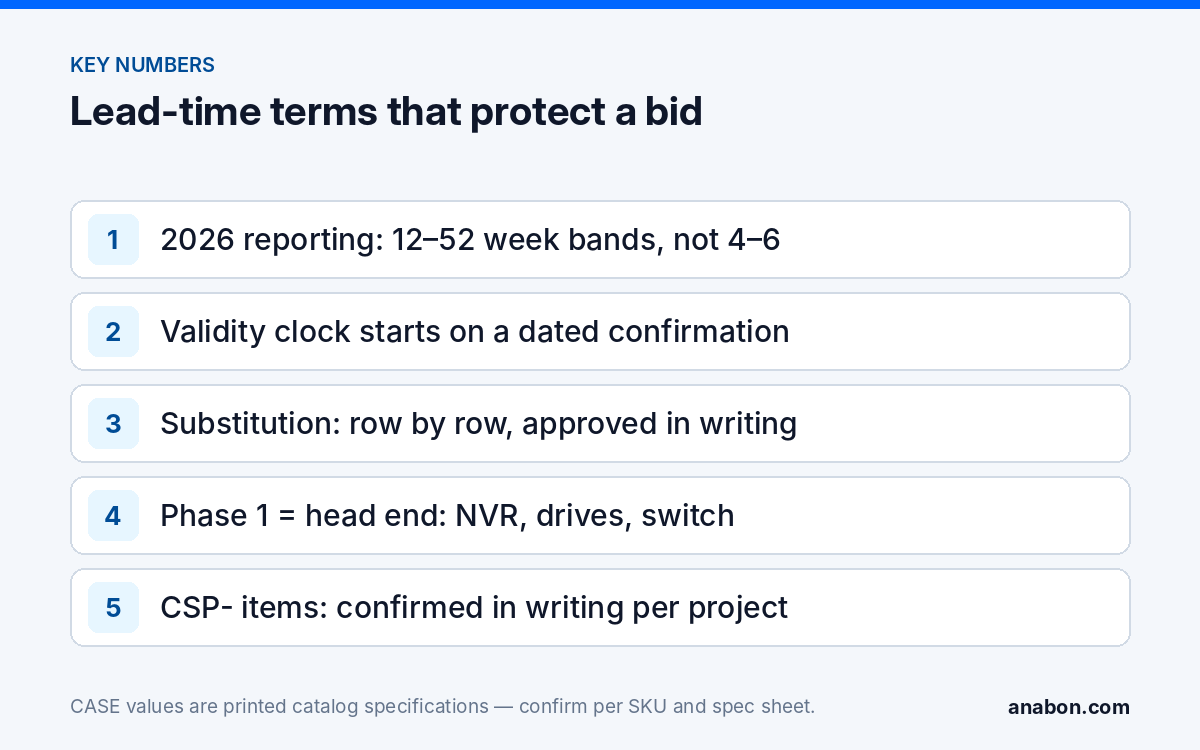

Use dated, per-SKU supplier confirmations to plan quote validity, approved substitutions and delivery phases. The 2026 industry figures are component-market context, not a CASE delivery commitment.

By Anabon Security Inc. — Technical Support · 10 min read · For installers, integrators and dealers

Quick answer: Obtain a dated written supply confirmation for each full SKU/revision, quantity, drive option, destination and required date. Agree offer validity, the release milestone, reservation conditions, substitution procedure and any phased delivery under the actual contract. A market report, catalog or quotation alone does not reserve equipment, guarantee delivery or authorize a replacement. Reconfirm what is firm, estimated or still pending before committing.

On this page

Why do security camera lead times matter more in 2026?

Availability can change between estimate, award and release, with different constraints for the recorder, drives, mounts and power variants. Use the project design review guide to identify technical inputs while keeping supply confirmation separate. Check actual freight, cross-border and commercial conditions, and record the dated basis and re-confirmation trigger for each offered item.

Coordinate technical fit, supply assumptions and written terms before pricing. The following table identifies questions to resolve with the supplier and buyer; it is not a current stock list, standard delivery period or promise that every alternate will be accepted.

Why do security camera lead times matter more in 2026?
Line item class Why schedule risk differs What to have in writing before bid
Fixed cameras (turrets, domes, bullets) Highest quantities; one SKU letter changes the model, so an “equivalent” is never automatic Dated lead-time band per full SKU; a pre-identified alternate within the line
PTZ cameras Model-specific mounting, power and supply conditions; confirm the documented compatible PSE or power supply Lead-time band per SKU; power method from the spec sheet
NVRs and AI NVRs The head end; drives are a separate supply chain NVR lead time and drive supply confirmed separately; hard drives are supported through back-to-back manufacturer warranty
PoE switches, mounts, junction boxes Attach items that stall commissioning when missing Bundled on the same confirmation
CASE Project Series (CSP- items: explosion-proof, thermal, solar trailers, radars) Project-quoted; nothing is assumed Written confirmation of availability, certificate and lead time before the item appears in your bid

How do you write a quote validity clause that holds?

Quote validity and supplier lead time answer different questions. Define how long the offer may be accepted, which supplier confirmation it relies on, the release/start milestone and what is conditional. A dated estimate is not a reservation or guarantee unless expressly agreed. Public bid forms may impose an irrevocable period; check the actual conditions and obtain advice on any conflicting supply or substitution terms.

How do you write a quote validity clause that holds?
Element Why it matters Sample wording for a private-work quote
Validity period Starts the clock from a readable date “This quotation is valid for 30 calendar days from the date shown above.”
What is covered Ties the amounts to named SKUs and a stated schedule “The amounts and delivery periods apply to the models listed by full part number in the attached schedule.”
Lead-time basis Makes the band a quoted term, not a verbal estimate “Delivery periods are based on supplier confirmation dated [date] and are stated in weeks from release of approved submittals.”
Re-confirmation triggers Protects you between quote and order “Amounts and delivery periods are re-confirmed before order if any duty, tariff or supplier change occurs, or if the specification changes.”
Acceptance definition Stops a late deposit eating the lead time “Delivery periods begin on receipt of the signed acceptance, the agreed deposit and approved submittals, whichever is latest.”
Expiry behavior Avoids silent extensions “After expiry, the quotation is re-issued; it is not automatically extended.”

Record the confirmation date and assumptions beside the offer and delivery terms. Confirm the network video recorder and drives separately, then identify the actual release milestone and any approval/payment conditions. An approval stamp does not automatically start every lead time, and a dated estimate is not a reservation unless expressly agreed. The sample clauses are private-work drafting prompts for review, not terms that override a mandatory bid form or guarantee enforceability.

What does approved-equal substitution language look like?

Use the actual substitution clause, form, deadline and approval authority. A clause can provide a route to request a different product; it does not automatically authorize a replacement or a free upgrade. For US federal solicitations using FAR 52.211-6, compare the stated salient characteristics and identify the offered item and supporting data. That provision is not the authority for every Canadian or private-work contract.

Sample clause

Possible discussion wording, subject to the actual agreed contract: “If a listed model cannot meet the confirmed delivery period, the contractor may request an alternative through the required procedure, identifying the exact model/revision, evidence, differences and unresolved checks. No substitution is treated as accepted until the required authorized decision is recorded.” Confirm the wording and any order/delivery restriction for the actual project.

The comparison itself is covered in “Or Equal” Substitutions: Building an Equivalence Table for CASE SKUs.

Why a same-line swap is still a substitution

A newer product name does not establish equivalence. Catalog physical page18 contains two printed configurations but inconsistent I/II labels, so the headers below identify columns rather than certify orderable model/revision attribution. Use the current manufacturer sheets and written clarification before assigning either column to CS-I8XQ I-2.8mm or CS-I8XQ II-2.8mm in a proposal.

What does approved-equal substitution language look like?
Printed row Catalog p.18 first printed configuration — verify full SKU/revision Catalog p.18 second printed configuration — verify full SKU/revision
Image sensor / lens 8MP / 2.8mm Fixed 8MP / 2.8mm Fixed
Max. IR distance 98 ft (30 m) 164 ft (50 m)
White light distance 49–66 ft (15–20 m) 98 ft (30 m)
Max. resolution and frame rate 3840×2160@20fps 3840×2160@30fps
Memory slot 512 GB 1 TB
Red and blue light No Yes
Protection / housing IP66 / Metal IP66 / Metal
Min. illumination 0.002 Lux 0.002 Lux

The current catalog/model guide helps identify source and naming questions, but exact revision evidence still controls the proposed comparison. A favorable row may be a match, an excess capability or a relevant difference under the actual requirement; it is not automatically an accepted deviation. The second printed configuration lists additional analytics, whose actual SKU attribution, firmware, function and permitted use need confirmation. A visible-light smoke/fire feature name does not establish a certified life-safety system. Disclose the differences and obtain the buyer’s required decision before relying on a replacement.

  • Name the alternate at bid time where the procedure allows it.
  • Compare models, not brands.
  • Carry the substitution into the schedule, the BOM and the as-builts the day it is approved.

How do you phase delivery and partial shipments?

Use the post-award submittal guide to record agreed approvals and dependencies. Phase delivery and commissioning only where the buyer, contract and supply plan permit it. Agree release, storage, risk, invoicing, payment, acceptance and warranty milestones for each phase. A phased plan does not shorten manufacturing time or create a right to partial payment.

How do you phase delivery and partial shipments?
Phase Scope Release trigger Acceptance
1. Head end NVR, drives, PoE switch, rack, UPS (for example CS-N220 P16H-AI with its 16 PoE ports, so the first cameras commission on the recorder itself) The actual agreed order/release milestone, required approvals and dated supply confirmation Only the authorized tests and phase acceptance agreed in the contract; a one-camera or remote-view test is not whole-project acceptance
2. Long-lead devices PTZ, panoramic and special cameras, any CSP- item with written confirmation At the agreed release milestone after required approvals and written supply confirmation Devices mounted, aimed and recording per the schedule
3. Fixed cameras by area Building, floor or parking zone batches Rolling, per the confirmed band Per-zone commissioning sign-off
4. Closeout Training, as-builts, warranty statement Last zone accepted Agreed closeout/acceptance milestone; warranty start follows the actual written terms

Clauses that make phasing enforceable

  • Partial delivery: agree whether deliveries, invoicing, payment and acceptance are permitted by phase. Sample wording is a contract discussion point; it does not create an enforceable entitlement on its own.
  • Phase completion: agree the actual acceptance and workmanship-warranty milestones in the contract. Product warranty start dates and exclusions follow the written terms for each supplied item and may differ from installation or phase acceptance. General category policies are a starting point, not a warranty for every SKU. Confirm the term, exclusions and claim process for the exact model and revision in writing. Project Series items, intercoms, powered accessories and model-specific exceptions need their own confirmation; hard-drive claims follow the applicable drive-manufacturer terms.
  • Storage of early material: who holds delivered equipment between phases, where, and under whose insurance.
  • Schedule float: state the confirmed band as a range and plan commissioning on its late end.

What should you confirm with your distributor before you submit?

Bring us the opportunity before you say no, and bring the schedule with it. Anabon Security Inc. is a North American B2B distributor of CASE and other professional security brands; we support the partner behind the scenes, and the quote stays yours. Before you submit, have these in your file:

  1. A dated, per-SKU lead-time confirmation for every line on the camera schedule, with full part numbers (CS-I8XQ II-2.8mm, not “8MP turret”).
  2. Drive supply confirmed separately from the recorder.
  3. A documented alternative, where permitted, compared against the actual requirements with both current revision sheets; same family or newer name does not establish equivalence.
  4. For any CSP- Project Series item: availability, certificate and lead time confirmed in writing for this project, or the item stays out of the bid.
  5. Evidence required by the bid: request the actual records for each offered SKU/revision/configuration, separating procurement restrictions, origin and technical approvals. A request, catalog statement or broad brand letter does not guarantee that every record is available or accepted.
  6. A demo if the evaluator wants one: for approved demo products we provide a 90-day test period under the approved demo return process. This is not a general return policy.

Quote from the dated confirmation and actual agreed terms, recording any reservation, conditions and expiry. Use the warranty-by-category guide to identify questions about the supplied item’s term, start milestone and service route; the guide or catalog badge does not replace the exact order’s written warranty.

What to tell your customer

After checking the underlying confirmations, a cover note can identify the offer expiry, source/date of delivery estimates, release conditions and any agreed phased plan. State that a proposed replacement follows the buyer’s actual review procedure. Do not promise that the recorder arrives first, every phase is billable or the last camera cannot affect completion unless the accepted contract and confirmed supply plan establish that result.

FAQ

How long are security camera lead times in 2026?

There is no single current lead time for a camera system. The cited 2026 industry report concerns component supply, not your CASE order. Obtain a dated confirmation for the full SKU, revision, quantity, drive option and destination, including the start milestone, conditions and whether anything is actually reserved.

How long should a security camera quote stay valid?

Use the validity period required by the actual bid or agreed private-work contract. Compare it with the supplier confirmation, release conditions and re-confirmation triggers before committing. A sample 30-day clause is not a universal rule, and a supplier’s shorter confirmation does not override a buyer’s mandatory conditions.

Can I substitute a newer model if the quoted one is unavailable?

Follow the actual substitution procedure and obtain the required written decision before relying on an alternative. Newer names or a longer IR figure do not prove equivalence. The catalog I/II attribution issue above must be resolved with exact revision documents. Ask security camera technical support for available model evidence, then disclose differences and pending items to the authorized reviewer; technical assistance is not buyer approval.

Does Anabon reserve stock for a bid?

Do not assume stock is reserved or delivery guaranteed because a bid received a quotation. Ask Anabon what the dated confirmation covers, whether a reservation is explicitly agreed, how long it lasts and what conditions apply. A Project Series configuration also needs the written project-specific availability, documents, delivery and warranty confirmation before it is offered.

References

  • Anabon current documents and manuals
  • Discuss the project and required documents
  • 2026 component-market context: SDM reporting on Novaira Insights; not CASE lead times


Product documents and project support

Match the current product documents to your full equipment schedule before quoting.

Private pricing is available through your approved business account. Confirm the exact model, revision, required functions and written warranty terms for your project.

FOR SECURITY INSTALLERS & INTEGRATORS

Find Your Next Project with Free Bid Alerts

Receive timely email updates about security tenders and project opportunities, organized by the states or provinces you choose. Register your interests below — this service is free.

Free project design guidance, 24/7

Anabon helps installers and integrators with system design and bid preparation. Get free guidance as you plan the project and prepare your proposal.

Call Our Team: +1 289 800 9000
Choose Your States & Request Free Bid Alerts

Where would you like to find your next project?

Choose your country and the states or provinces you want to follow, then submit your request.

Bid Opportunities

Explore Past Security Bid Opportunities

Examples from our archive. The submission deadlines below have passed; these are not open invitations to bid.

Browse all bid opportunities

Are you an end user rather than an installer? For warranty and service, please contact the installer or company that supplied your system. Anabon supports warranty and technical service through our installer, dealer and business-account network.

Scroll to Top
