Quick answer: Give a self-storage system clear jobs at entrances, corridor junctions, lift or stair routes and vehicle gates. Test those views with normal doors and lighting. Remote viewing is a management convenience; verify the actual local recording and fault-response design separately, including what happens when the internet connection is unavailable.
On this page
Plan around when the problem is discovered

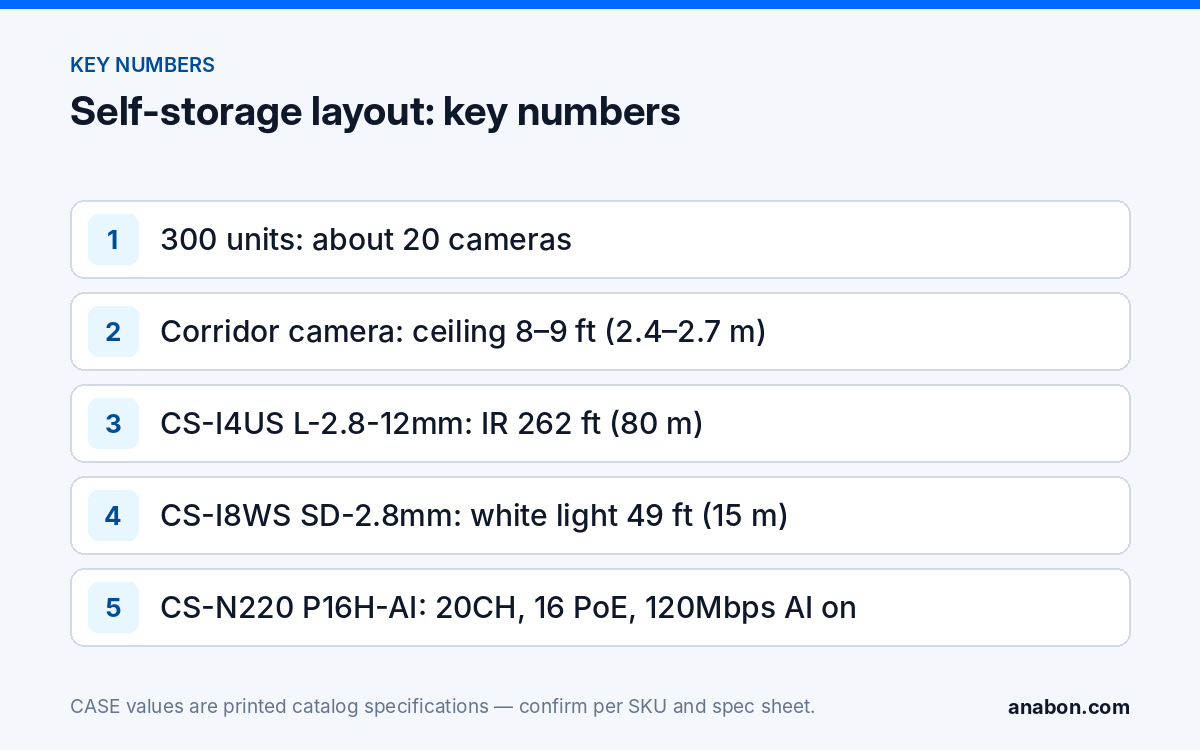

Ask how customers report an incident and how long a unit may remain unvisited. Use those discovery delays to agree recording and preservation needs, not a universal legal retention period. Identify who can protect footage before overwrite. Walk the actual public entry, reception, loading, lift, stair and gate routes with normal doors, carts and shutters in use. A three-hundred-unit example does not determine a twenty-camera design. Shared-building camera planning offers a related way to organize common routes; define each position’s actual evidence task.
Check usable detail along corridors
A long straight corridor can look covered in a wide image while a person at the far end is too small for the requested task. Compare IP cameras against the actual scene width, mounting point and light. Test a person moving near, midway and at the important far position, using saved footage.
| Area | Purpose | Acceptance check |
|---|---|---|
| Public entry or loading | Arrival and movement of goods | Carts, open doors and normal delivery positions. |
| Corridor junction | Travel between agreed routes | Near and far movement with unit doors open. |
| Lift or stair lobby | Connection between floors | Corners, door swings and normal reduced lighting. |
| Vehicle gate | Entry, departure and site route | Headlights, queue positions and night operation. |
Do not aim into private storage units unnecessarily when doors open. Agree the boundary and any supported masking with the operator. Test the actual recorded result after adjustments. Avoid promising a fixed recognition distance from a general resolution or lens description.
Keep gate evidence and gate control separate
Ask whether the gate requirement is an overview, a readable plate or automatic recognition. Each needs its own scene and support review. A general entrance view or a Plate Search label does not establish a validated plate-recognition installation. Document any relationship with the access-control or intercom system separately. Confirm exact supported interfaces and responsibilities rather than implying a camera controls the gate. A surveillance camera is not a gate safety sensor; have the gate contractor maintain the actual safety and control system. Use the gate integration planning guide to separate approved recording, visitor communication and control responsibilities.
Test the unattended site after dark
Repeat the walkthrough with the normal after-hours lighting and authorized vehicle movements. Check reflective doors, deep shadows, headlights and light falling from an open loading bay. Review saved clips, not just the mobile live view. Reposition, reframe or improve appropriate lighting if the requested detail is not useful. For a warning light or audible deterrent, confirm the exact supported equipment, trigger, schedule and response contact. Consider neighbouring properties and legitimate late customers. Do not promise that a warning prevents entry or that an unattended site is continuously watched.
Separate recording capacity from remote convenience
Size the recorder for the full channel schedule, supported incoming bandwidth, usable storage and planned growth. Using all twenty supported channels leaves no spare channel headroom. Check PoE loads, power, communications and the customer-approved network architecture. Safely test the agreed link-loss scenario: which local recordings continue, which remote functions stop and who checks recovery. Confirm the supplied software against the exact model, firmware, platform and documentation. An app screenshot proves neither recording continuity nor notification behaviour; remote viewing is separate from a monitoring contract.
Equipment example: A current recorder example, CS-N220 P16H-AI, lists twenty channels and sixteen PoE ports (catalog physical page 55). A twenty-channel schedule would consume its listed channel count; it would not create spare channel capacity. Review storage, bandwidth, expansion and the supported remote workflow separately for the actual site.
Make the owner able to operate and recover the system
Give the manager and installer separate named roles, with customer-controlled ownership and secure recovery. Revoke access when responsibilities change. Have the operator establish its actual notices, retention and disclosure rules. OPC overt-surveillance guidance concerns private organizations in publicly accessible areas and excludes employee and covert surveillance; it does not approve every storage-facility use. Keep collection proportionate to the agreed purpose, and do not distribute general access to shared footage or track customers for unrelated reasons.
Demonstrate discovery, preservation and export
Create a harmless test journey from the gate to a nominated corridor. Retrieve it by time, preserve the agreed period, export it and replay it with the manager. Verify labels and time configuration. Check the oldest available recording after the agreed run-in period rather than treating the storage calculation as the final proof. Leave the as-built plan, firmware schedule, accepted views, role ownership and fault-response instructions. Obtain exact-model instructions from the Anabon Download Center. Include checks for changed lights, obstructed lenses, moved shelving and recording warnings, with safe maintenance access.
FAQ
Does remote viewing mean recording depends on the internet?
Not necessarily. The multi-building recording guide helps compare the architecture and link dependencies. Test the agreed outage on the actual system rather than assuming continued recording or total loss from an app view.
How long should a self-storage site keep footage?
The operator must establish the applicable target and preservation process. Consider discovery delays, privacy and actual obligations, then size and verify the recording system.
Review the site before ordering
Send security camera technical support the routes, corridor distances, night photographs, connection constraints and approved recording target. Identify where privacy boundaries, channel growth or recording continuity still need confirmation.
References
References reviewed October 30, 2026. OPC, Guidelines for Overt Video Surveillance in the Private Sector (March 6, 2008), within its stated scope; confirm actual project privacy, access and retention requirements. Recorder example: current CASE catalog, physical page 55. This is not a site-specific compliance or capacity acceptance.
