Quick answer: Build a security camera installation proposal from the survey: the requirement, proposed design, exact equipment, included work, dependencies, acceptance tests and support terms. Give the decision-maker a clear summary and the delivery team enough detail to implement it. A template improves consistency; it does not guarantee a sale or replace site-specific design and reviewed contract terms.
On this page
Start with a requirement you can test
State what the customer needs to observe, record, retrieve or operate. Distinguish an overview from identification detail, including distance, lighting and operating conditions. Treat the design as an objective to test; resolution or illumination alone does not guarantee it. Record access, pathways, existing equipment and network approvals, and put unresolved assumptions in a visible dependency list.
| Section | Fill in / attach |
|---|---|
| Summary | [Customer requirement, proposed approach and main unresolved dependency] |
| Survey and design | [Approved site findings, view purposes and design limitations] |
| Equipment schedule | [Complete SKU/revision, quantities, compatible mounts and required records] |
| Installation scope | [Pathways, access equipment, trades, permits, making-good and exclusions] |
| Configuration and handover | [Recording, accounts, approved remote path, training and as-built records] |
| Acceptance | [Tests, conditions, reviewer, evidence and process for open items] |
| Warranty / support / maintenance | [Separate written product, workmanship and service terms] |
| Programme and commercial terms | [Lead-time assumptions, milestones, validity, private quotation and change process] |
Make the camera schedule do useful work
Use the camera schedule and bill-of-materials guide to give required views stable identifiers and map them to the actual device, lens and recorder stream/channel. Carry the mapping through cable labels and handover records; do not assume one physical device always equals one view or channel. Limit sensitive site details to appropriate recipients.
| View / purpose | Equipment / dependencies | Acceptance evidence |
|---|---|---|
| [C-01; authorized location; required detail] | [Full SKU/lens; mount; power/network; run design] | [Target, distance, lighting and test record] |
| [C-02; overview or other requirement] | [Exact equipment and interface requirements] | [Test conditions and reviewer] |
Attach the actual specification sources and revision/date for each complete proposed SKU. Another model’s row is not evidence for this item. Check the full installed network channel, power and environment rather than copying example cable lengths. Confirm relevant ONVIF profiles and the functions tested on the exact device/software combination; a brand statement alone does not establish interoperability.
Define the work and its boundaries
Identify who supplies power, approves network settings, provides internet access, arranges lifts and permits, and restores disturbed finishes. Include commissioning, documentation and training explicitly. “Install cameras” does not resolve who configures retention, manages accounts or tests export.
Use the pre-bid site-walk checklist to identify access and pathway assumptions before quoting. State exclusions plainly with their consequences and the approval needed if an assumption fails. Do not use an exclusion to remove necessary safety work or obligations that still apply to your company.
Include a controlled substitution process. A replacement needs more than a similar camera count: review view performance, mounting, power, events, storage and documentation. Obtain approval before ordering a material change rather than editing the equipment schedule silently.
Make handover and acceptance specific
Agree tests for required views, recording, time, authorized access, supported event actions and export. State what will be checked at handover and what needs a later observation window. A new system cannot demonstrate a full retention history before that much time has elapsed.
Record an owner and due date for each open item. The project handover guide helps organize accepted revisions, training and closeout records; preserve the approved proposal and test evidence together. Acceptance of a defined result is not a guarantee of uninterrupted operation, crime prevention or regulatory compliance.
Confirm CASE Connect functions for the installed model, software and configuration before promising a handover workflow. Do not assume identical app/web features across systems.
Separate warranty from service
State product warranty from the exact supplied SKU and written terms. General category descriptions and printed badges can differ. Address your workmanship, labour, diagnostic visits, transport and maintenance separately rather than treating a product warranty as free on-site service.
Explain how the customer reports an issue and how the installer coordinates distributor support. Use the warranty and RMA process guide to prepare the record, then confirm actual eligibility, assessment, replacement, freight and timing. Do not promise immediate replacement or stock. Compliance-sensitive commitments require the actual clause and supporting exact-item records.
Review the quote and next step
Keep the proposal costed from your actual scope using the installation pricing workflow. The equipment must remain identifiable even when the private commercial quotation groups costs by section. Do not hide material exclusions to make a comparison look favourable.
Give the recipient one clear next step: approve a survey clarification, review an equipment schedule or accept the properly reviewed proposal. State validity and lead-time assumptions; do not present a hopeful installation date as confirmed supply.
For partner-side equipment and documentation help, request a security camera project quote from Anabon with permitted requirements, complete proposed SKUs/revisions and the deadline. Confirm available records and supply assumptions before using the response in your independent customer proposal.
FAQ

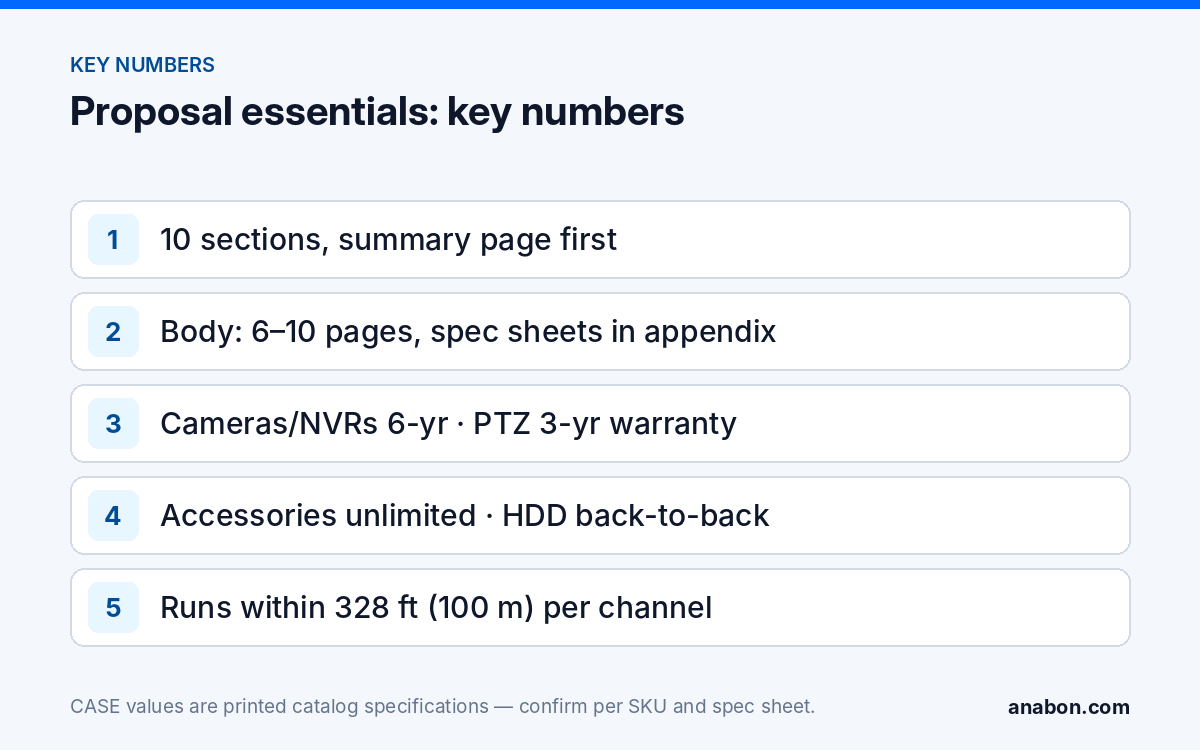

How long should the proposal be?
Long enough to explain the decision and define delivery. Put detailed schedules and evidence in controlled appendices; there is no universal page count that wins a commercial job.
Can I use the same template for every customer?
Reuse the structure, not the site findings or promises. Rewrite requirements, assumptions, equipment and tests for each job, and review the actual contract terms before use.
